"I'm on a boat": Part IV
The Oakland Alameda Water Shuttle is likely the most universally loved of local transportation initiatives.

The Oakland Alameda Water Shuttle is likely the most universally loved of local transportation initiatives. Unlike street safety projects, with geometric constraints that can become zero-sum debates, the Water Shuttle is purely additive — a useful new connection, where none existed before. Plus, it's an enjoyable ride!
At the May meeting of the Alameda city Transportation Commission, city staff shared that:
In April, the Water Shuttle had its busiest month since August, carrying 9,600 passengers and 2,122 bicycles. Since launching on July 17, 2024, the Water Shuttle has served over 83,000 passengers, with an average daily ridership of 413.

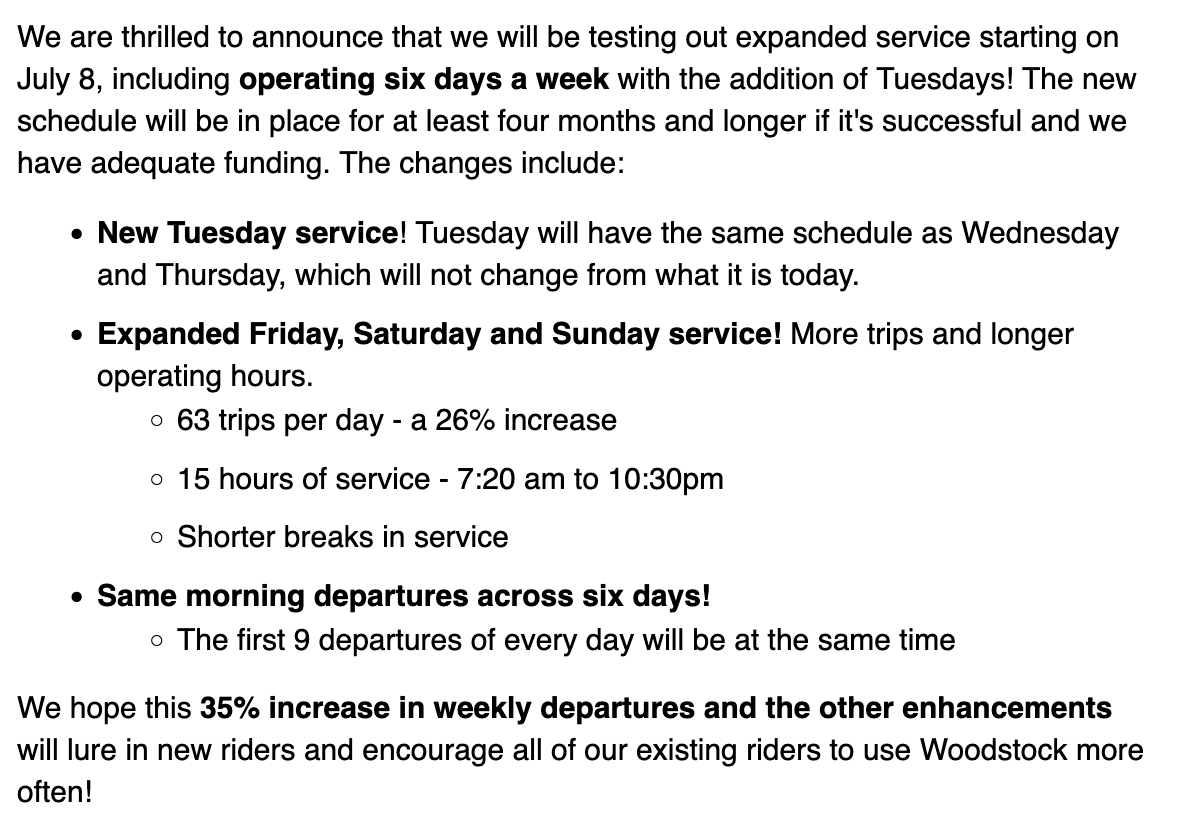

This week, the City of Alameda announced an expansion of Water Shuttle service:

The Water Shuttle service is still heavily constrained by having a fleet of one single vessel. When there's a problem, service must be fully halted. Nor is there an ability to increase frequency during peak times of travel. Still, within these constraints, the Water Shuttle's planning and operating partners are creatively experimenting and optimizing the schedule to best meet usage by a wide range of users.

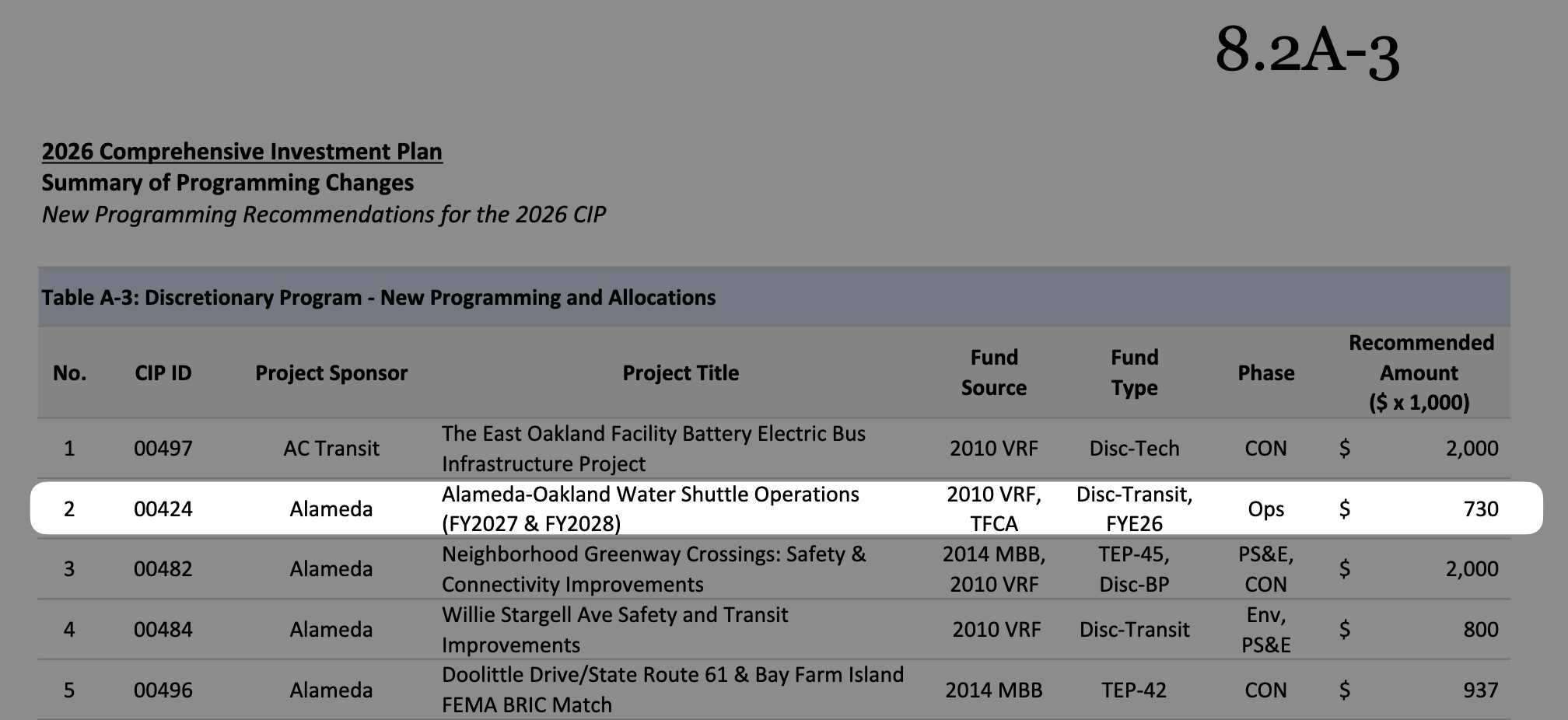

The partners are also pursuing funding to continue the service. At its May meeting, the Alameda County Transportation Commission took action toward supporting two more years of Water Shuttle operations:

Thank you to ACTC staff and board (including ACTC Vice Chair Marilyn Ezzy Ashcraft). These funds will be combined together with funding from other sources, including the Alameda TMA and its members, to hopefully continue operations for two more years.
City of Alameda has also requested additional support to operate and expand the Water Shuttle from the Port of Oakland, which is planning a massive construction project nearby. In a 2,045-page PDF released this month, the Port of Oakland said nope, we're not going to help with your water shuttle. You have a boat, what use is another? Plus, we suddenly forgot the distinction between capital and operational expenses, so you can't possibly need money to pay people to actually make that one boat go back and forth. Anyway, that's a whole 1,500 feet away from our construction site and we don't understand how transportation networks work...

Here's a video explaining the goals of the project.
Hardly mentioned in the video is that this will involve removing a circular shaped portion of shoreline from western Alameda — and trucking it all to off-island landfills.
Back in 2023, the City of Alameda requested mitigations, to eliminate or reduce the impacts of the tens of thousands of dump-truck trips that may be involved in moving all that dirt. Expanding Water Shuttle service is just one of many substantive proposed mitigations to the heavy truck traffic and resulting air pollution proposed by Alameda.

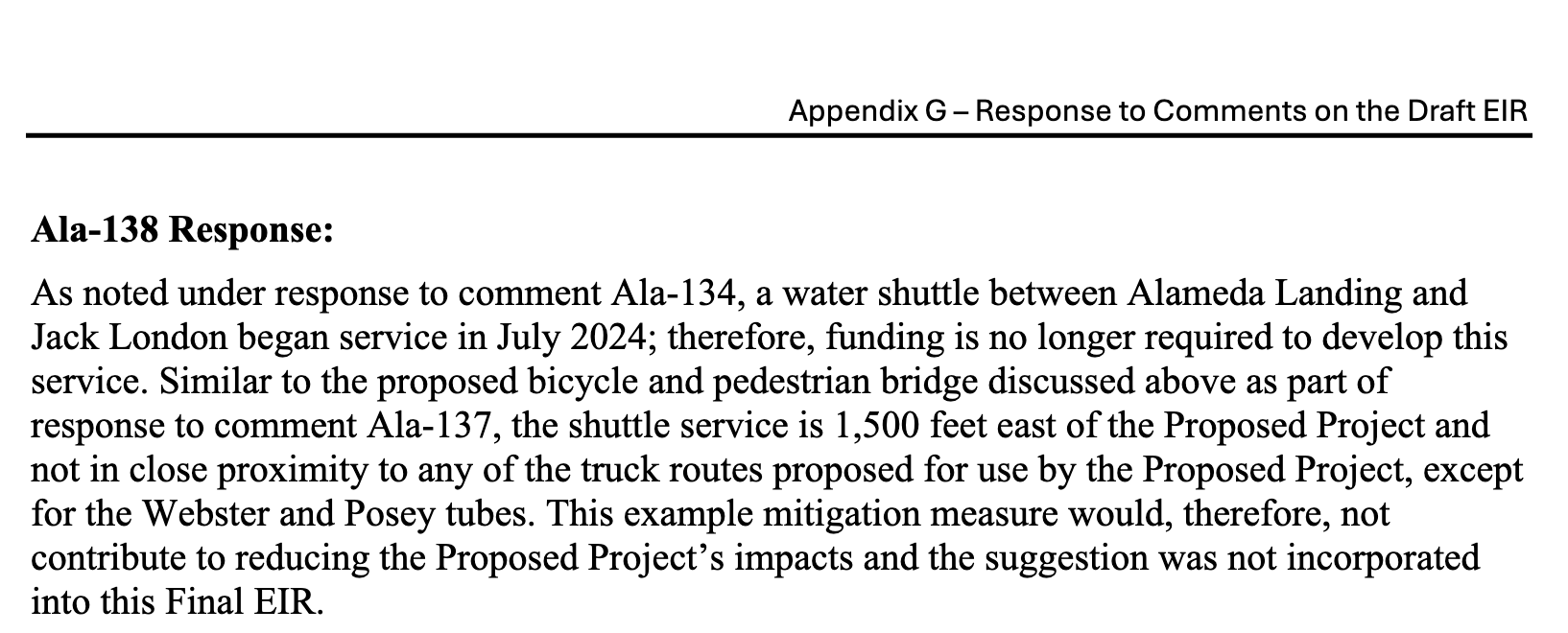

But based on a skim of the final EIR, it looks like the response from the Port of Oakland (or its consultants) to the City of Alameda's request for mitigations is whatevs, we're just gonna remove City of Alameda as an authorizing agency from this project's docs.
It's unfortunate that for such a successful service, the Water Shuttle's partners still have to work so hard to secure funding to continue its operations. Perhaps that's just the nature of operating most any public service in post-Prop 13 California, and even more so in the America of Musk and Trump. In any case, this is a valuable service and worth the trouble.
Thanks to involved in continuing the Water Shuttle, making it an even more useful means to bridge this watery gap, and taking incremental steps toward the permanent solution of a bike/ped bridge to knit together western Alameda Island and Oakland's Jack London Square waterfront.
